Service 03 — The verdict

The curve that
ends the argument.

Independent power performance testing to IEC 61400-12-1. One measured power curve — the same number the OEM, the owner and the lender all read — for warranty close-out, acceptance, upgrade validation and dispute resolution.

  • IEC 61400‑12‑1
  • Independent
  • Bankable reporting
Worked example · reading the 11.4 m/s bin Warranted curve Measured curve Deviation
≈6% shortfall 025 5075100 510 152025 Power — % of rated Wind speed — m/s
Cut-in3.0 m/s
Rated12 m/s
Measured / warranted94 % AEP
Typical AEP uncertainty4–8 %

Worked example — real campaign results are confidential · method: IEC 61400-12-1 method of bins — each point is the mean of a 0.5 m/s wind-speed bin, density-normalised, with per-bin uncertainty stated

Siemens Gamesa ReNew Adani DNV Vestas Greenko Engie Azure Power Suzlon Tata Power CleanMax AMPYR Deutsche WindGuard JSW Energy GE Enel Vena Energy EDF Inox Wind BrightNight UL Solutions Hero Future Energies Acciona Energía Envision BluPine Energy Torrent Power Juniper Green Energy Alfanar Senvion Blueleaf Energy Vibrant Energy Zelestra NISE Hinduja Renewables Sprng Energy AMPIN Energy UPC Renewables Levanta Renewables Solarpack Fourth Partner Energy WEG
61400‑12‑1IEC method, to the letter
3Parties, one curve
16Countries measured
0Position we hold in the result

The measurement chain

The turbine never grades its own homework.

Power is measured independently — class transducers on the turbine’s own CT/VT taps, logged beside an isolated met-mast reference, time-synchronised into one dataset. Click any element of the chain.

TURBINE OUTPUTCT · VT · L1 L2 L3 POWER TRANSDUCERISKRA UMT 540 LOGGER-1INDEPENDENT · AMMONIT MET MASTREFERENCE WIND TURBINE PLC / SCADAOPERATIONAL DATA SYNCHRONISED 10-MIN DATASET IEC 61400-12-1 ANALYSIS ELECTRICAL MEASUREMENT METMAST MEASUREMENT OPERATIONAL · FILTERING ONLY
The campaign architecture · three streams, one clock, one verdict

Logger-1 · independent

Power, measured by us

A dedicated Ammonit logger records the transducer’s output — high-resolution acquisition, synchronised 10-minute statistics, data integrity checks and remote transfer. Independent of the turbine’s own metering, end to end.

All instruments calibrated and installed to IEC 61400-12-1. The turbine’s own SCADA is used to filter operating states — never as the measurement.

The measurement, in the field

Ground, or from the nacelle.

Both to IEC 61400-12-1 — we choose the method that fits the terrain, the fleet and the question the test must answer. Toggle the method, drag to orbit.

TEST SETUP · LIVE 3D · DRAG TO ORBIT
GROUND LIDAR · 2.5 D UPWIND
Blue ring — the rotor span the test must characterise · orange pulses — the power being measured · NTS

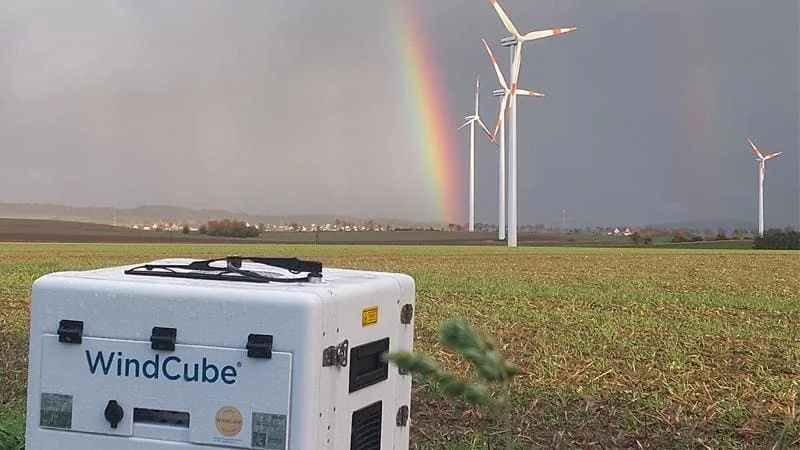

A WindCube ground LiDAR standing in a field after rain, wind turbines and a rainbow behind it
Ground LiDAR on site · the free-stream reference
  • SeesThe free-stream inflow across the full rotor, from a fixed point 2–4 D upwind (2.5 D shown).
  • FitsSingle-machine tests, complex terrain, warranty and acceptance where the free stream is the reference.
  • GivesA profiled wind field the standard’s method of bins is built around.

The standard, evolved

IEC 61400-12-1, edition 1 to edition 2.

The method behind every bankable curve was rewritten in 2017. Edition 1 (2005) read the wind at one height — the hub — with a cup anemometer on a mast. Edition 2 (2017) reads the whole rotor, folds shear and veer into a single rotor-equivalent wind speed, and lets a verified LiDAR stand in for the mast. Toggle the edition.

HEIGHT WIND → HUB HEIGHT 1 measurement height ROTOR-EQUIVALENT ≥ 3 HEIGHTS · REWS
Wind speed rises with height (shear) · Ed.1 samples the hub only · Ed.2 samples across the rotor and combines to REWS · NTS
Edition 2 · the headline change

Rotor-equivalent wind speed

The curve is referenced to the wind across the entire swept rotor — not one hub reading — so shear and veer no longer bias the result. The measured curve tracks what the blades actually see.

Reference height
Hub height · one height
Rotor-equivalent · ≥3 heights (REWS)
Instrument
Cup anemometer on a met mast, 2–4 D upwind
Cup, or a classified & verified LiDAR / SoDAR
Shear & veer
Unseen — one height can’t read the profile
Integrated across the swept rotor
Turbulence
Not treated
TI reported · normalisation defined
Uncertainty
Category A + B, basic combination
Expanded — mounting, flow & correlation

Unchanged in both editions — the method of bins · 0.5 m/s wind-speed bins · ≥30 min per bin · ≥180 h total · air-density normalisation · a defined valid measurement sector.

IEC 61400-12-1:2005 → :2017 · the principal changes, in brief — we test to the edition your contract and warranty specify.

Why it holds

A power curve is only worth what it can survive — and ours is built to survive the other side’s engineer.

2016Independent since
A + BUncertainty · statistical + instrument
Ground & nacelleLiDAR, calibrated
Line by lineDefensible to the standard

Why the air matters

Same turbine, different air.

Twelve months of real hourly wind at a southern-India hill corridor — each dot is one hour, plotted as wind shear (10 → 100 m) against hub-height speed and coloured by the hour’s atmospheric stability. Stable nights stack the shear high; convective afternoons collapse it — the same wind speed hits the rotor with a completely different profile, which is why a bankable test filters and bins to IEC 61400-12-1 instead of averaging blindly. Toggle the classes.

0.15.30.45.60 0481216 WIND SPEED AT 100 m · m/s SHEAR EXPONENT α · 10→100 m Night mean α    Day mean α
Loading 12 months of real hourly wind …

Real 12-month window · hover to isolate · click to hide

Stable night air rides high shear — the rotor top sees far more wind than the bottom; convective afternoons mix it flat. A power curve measured without accounting for this blends different machines’ behaviour into one false average. The standard’s answer is discipline: filter, normalise for density, bin by the method of bins — and state the uncertainty per bin.

What the curve decides

A power test moves money.

The gap between the measured curve and the warranted curve is not academic — it is a payment, an acceptance, or a dispute. Which is exactly why the one thing it cannot be is partial.

Warranty

Close out the guarantee.

The measured curve settles the power-curve warranty at end of term — either the machine met what was sold, or the shortfall is quantified in kWh and defensible against the contract.

Acceptance

Take the asset over.

At handover, an independent power performance test is the evidence acceptance turns on — the owner and the lender sign against a measured curve, not a promised one.

Upgrade & dispute

Prove the change — or the claim.

Validate a power-curve upgrade against a measured before-and-after, or resolve a yield dispute with a curve that survives the other side’s independent engineer.

How a campaign runs

Six steps from scope to signed.

Every campaign follows the same disciplined path — from the question the test must answer to a report that stands up in review. No step is skipped, and each one is documented.

Week 101Scope

Define the question.

Warranty, acceptance, upgrade or dispute — the decision sets the method, the sectors and the acceptance criteria before anything is installed.

Week 1–202Instrument

Deploy the LiDAR.

Ground-based or nacelle LiDAR, calibrated and traceable, sited to see the free-stream inflow the standard is built around.

Ongoing03Measure

Capture the field.

Wind and power logged across the bins, through the valid sector, until every bin holds enough data to be defensible.

Post-campaign04Analyse

Filter, normalise, bin.

Availability and status flags applied, air density normalised, power binned by the method of bins — strictly to IEC 61400-12-1.

Report05Report

State the result.

The measured curve, its uncertainty and AEP against the warranted curve — with every deviation from the method logged and justified.

Close-out06Defend

Survive the review.

The report goes to the independent engineer and holds — the one number the OEM, the owner and the lender all sign against.

The impartial arbiter

Three parties. One curve.

Because we hold no position in the outcome, everyone at the table works from the same measured number. That is what turns a test from the start of an argument into the end of one.

The OEM

Wants the machine defended.

Reads the same curve, tested to the same method — a result it can stand behind, or dispute on the standard, not on our allegiance.

The owner

Wants the truth of the asset.

Sees measured yield against the curve that was sold — the basis for acceptance, warranty and every model downstream.

The lender’s engineer

Wants certainty to bank on.

The independent engineer (IE) reviews a report built to survive scrutiny — uncertainty stated, deviations justified, compliant line by line.

To the standard, or it isn’t a test

IEC 61400‑12‑1, line by line.

The standard is exact about sensors, siting, sectors and filtering. We test to it precisely and document every deviation and its justification — so the result is defensible point by point, not just a plausible curve.

Reference wind measured to spec — ground-based or nacelle LiDAR, calibrated and traceable.Reference wind
Measurement sector defined — obstacles and wakes assessed, invalid directions excluded.Siting
Air density normalised — power binned by normalised wind speed, method of bins.Normalisation
Data filtered and completed — availability, curtailment and status flags applied before binning.Filtering
Uncertainty quantified — category A and B combined per bin and carried into AEP.Uncertainty A+B
Every deviation logged — each departure from the method stated and justified in the report.Deviations
